[Editor's Note: This article will continue to be updated as new projects and updates are announced. Last update: April 5, 2025.]

On February 13, after much teasing, the Province of British Columbia finally unveiled the BC Builds program, one of the biggest initiatives the Province had said it would be launching to address the housing crisis and one of the biggest outstanding items from the housing platform Premier David Eby campaigned on in 2022.


What is BC Builds?

The goal of BC Builds is to create more housing that is affordable to middle-income renters, who are increasingly facing the same housing affordability issues that lower-income earners are. The Province says it understands that the private sector is facing challenges when it comes to building these kind of projects, so it is stepping in to address the need for this kind of housing, which the Province recognizes as the kind of housing that people such as teachers, nurses, and construction workers need.

How does BC Builds work?

BC Builds can be viewed as having three major components.

First, BC Builds will act as a so-called "land bank," by working with other government bodies, not-for-profits, First Nations, faith-based groups, and even private owners to identify land they own that is currently being underutilized.

Secondly, the program will then make that land available for development, whether it be to not-for-profits, First Nations, or even private sector developers. The housing that is being delivered must be provided at rental rates that cost no more than 30% of household income — the traditional definition of affordability — for middle-income earners and cannot exceed market rental rates in their respective communities.

Lastly, to get those projects to the construction stage faster — a big culprit in Canada's housing crisis — the Province will then provide low-cost construction financing, while also stepping in to expedite approvals when needed.

How much money is the BC Builds program distributing?

BC Builds launched with the Province committing $2B in low-cost construction financing. A week later, Prime Minister Justin Trudeau announced that the Government of Canada would be matching that funding and providing an additional $2B in financing.

At launch, the Province of British Columbia said it will also be committing $950M to BC Builds in the form of grants to not-for-profits and First Nations, in order to ensure the affordability of the projects. Those projects will be required to provide 20% of units at rental rates that are at least 20% below market.

In February 2024, the Province then announced a further commitment of $198 million to BC Builds as part of Budget 2024.

In March 2025, the Province announced a further $318 million over three years to BC Builds as part of Budget 2025.

How many projects will BC Builds fund?

At launch, the Province says it had identified 20 sites across British Columbia with more likely to be identified and or added later. It has also said that BC Builds will be expanded to include a homeownership program in the future. Currently, through the first five years of the program, the Province says that it projects BC Builds to deliver between 8,000 and 10,000 units.

For more background on BC Builds and how the development process will work, read our one-on-one interview with Minister of Housing Ravi Kahlon about the program.

Below is a map and full list with all of the announced BC Builds projects, both of which will be updated as announcements are made.

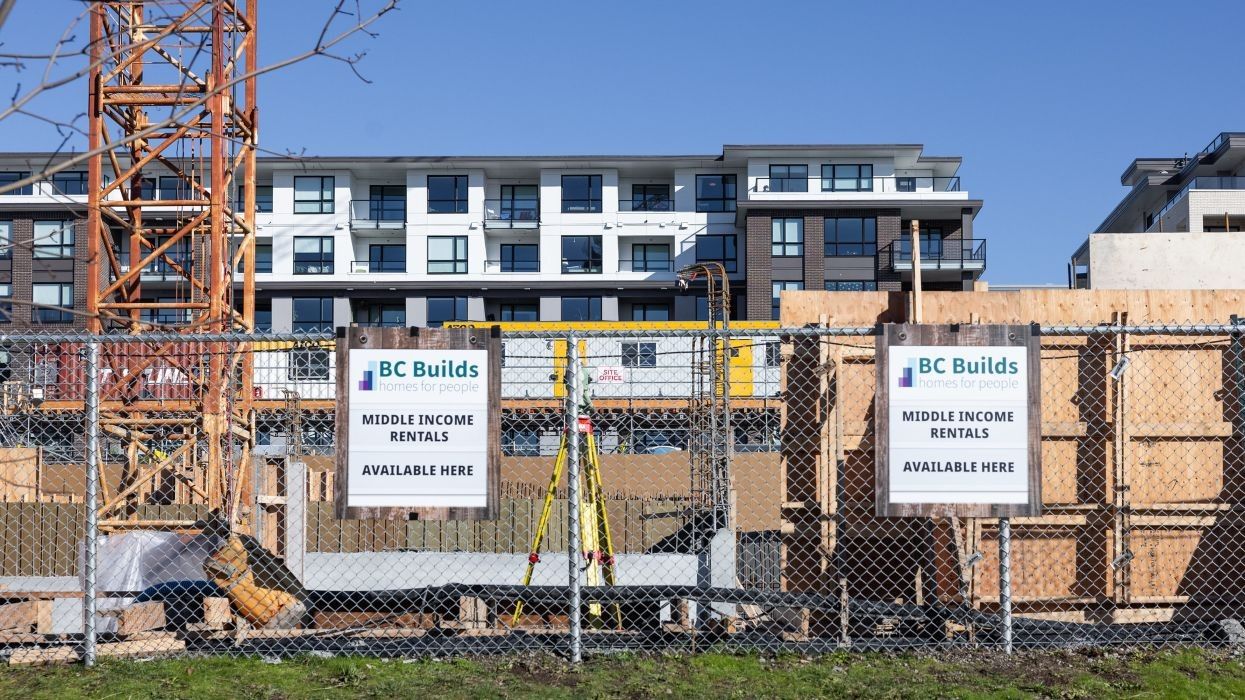

1. 225 2nd Street East (120 St. Georges Street), North Vancouver

  • Announced: February 13, 2024
  • Land Owner: City of North Vancouver
  • Developer: Catalyst Community Development
  • Amount of Units: 179
  • Project Details: An 18-storey mass timber building that will include the new North Shore Neighbourhood House, a community services provider, on the lower levels and rental housing on the floors above.
  • BC Builds Grant: $24.5 million
  • Status: Under Construction (April 4, 2025)
  • Announced: February 13, 2024
  • Land Owner: City of Duncan
  • Developer: Khowutzun Development Corporation
  • Amount of Units: 199
  • Project Details: 4 to 6-storey. Woodframe. New governance HQ for Cowichan Tribes.
  • BC Builds Grant: $38 million
  • Status: Under Construction (April 4, 2025)
  • Announced: February 13, 2024
  • Land Owner: Town of Gibsons
  • Developer: New Commons Development
  • Amount of Units: 33
  • Project Details: 4-storey. Woodframe. Operated by Sunshine Coast Affordable Housing Society. BC Builds is also providing $8.6 million in financing.
  • BC Builds Grant: $5.2 million
  • Status: Under Construction (September 6, 2024)
  • Announced: February 20, 2024
  • Land Owner: City of Vancouver
  • Developer: New Commons Development
  • Amount of Units: 112 (co-op)
  • Project Details: 9-storey. Concrete. Passive house. Development application submitted in March 2022.
  • Status: Pre-Construction
  • Announced: April 29, 2024
  • Land Owner: City of Kelowna
  • Developer: Housing Okanagan
  • Amount of Units: 149
  • Project Details:
  • Status: Pre-Construction
  • Announced: April 29, 2024
  • Land Owner: District of Sooke
  • Developer: Catalyst Community Development
  • Amount of Units: 89
  • Project Details:
  • Status: Pre-Construction
  • Announced: July 22, 2024
  • Land Owner: Resort Municipality of Whistler
  • Developer: Whistler Housing Authority
  • Amount of Units: 102
  • Project Details: Two four-storey woodframe buildings. BC Builds is providing a $12.7M grant and $27M in financing. Constructed expected to be completed in 2026.
  • Status: Under Construction (April 4, 2025)
  • Announced: August 13, 2024
  • Land Owner: Railtown Housing Society
  • Developer: Railtown Housing Society
  • Amount of Units: 55
  • Project Details: The building will be six storeys and the Railtown Housing Society was created by the Chamber specifically for this project to address the need for local workforce housing.
  • Status: Pre-Construction
  • Announced: August 13, 2024
  • Land Owner: City of Fernie
  • Developer: New Commons Development
  • Amount of Units: 44
  • Project Details: The Elk Valley Family Society will be the housing operator.
  • Status: Pre-Construction

10. 511 9 Avenue W, Prince Rupert

  • Announced: August 23, 2024
  • Land Owner: City of Prince Rupert
  • Developer: North Star Developments
  • Amount of Units: 40
  • Project Details: Aurora Housing has been selected as the operator.
  • Status: Under Construction (April 4, 2025)

11. 377 Tranquille Road, Kamloops

  • Announced: September 6, 2024
  • Land Owner: City of Kamloops
  • Developer: Arpa Investments
  • Amount of Units: 90
  • Project Details: The project will be a six-storey building at the former site of the Northbridge Hotel.
  • Status: Pre-Construction
  • Announced: September 9, 2024
  • Land Owner: Township of Langley
  • Developer: Caliber Communities
  • Amount of Units: 118
  • Project Details: Specific details, including refined unit counts, planned design elements, project funding and construction timing, will be made public once they are finalized.
  • Status: Pre-Construction
  • Announced: September 9, 2024
  • Land Owner: Township of Langley
  • Developer: Caliber Communities
  • Amount of Units: Approximately 128
  • Project Details: Specific details, including refined unit counts, planned design elements, project funding and construction timing, will be made public once they are finalized.
  • Status: Pre-Construction
  • Announced: September 9, 2024
  • Land Owner: Township of Langley
  • Developer: Edgar Development
  • Amount of Units: Approximately 122
  • Project Details: Specific details, including refined unit counts, planned design elements, project funding and construction timing, will be made public once they are finalized.
  • Status: Pre-Construction
  • Announced: September 9, 2024
  • Land Owner: 1070534 BC Ltd. and 1070537 BC Ltd
  • Developer: Tannin Developments
  • Amount of Units: 371
  • Project Details: The project is Phase 2 of The Colton, which will consist of four six-storey buildings and is expected to be completed in late-2027.
  • Status: Pre-Construction
  • Announced: September 9, 2024
  • Land Owner: The Neighbourhood Church (formerly Southside Community Church)
  • Developer: Gracorp Properties
  • Amount of Units: 480
  • Project Details: The project would be a 45-storey tower. Further details will be made public after rezoning approval, with construction currently anticipated to begin in late 2025.
  • Status: Pre-Construction

17. 2558 Quadra Street, Victoria

  • Announced: September 13, 2024
  • Land Owner: Greater Victoria Housing Society
  • Developer: Greater Victoria Housing Society
  • Amount of Units: 40
  • Project Details: The Greater Victoria Housing Society will also be the housing operator.
  • Status: Pre-Construction

18. 1276 Gladstone Avenue, Victoria

  • Announced: September 13, 2024
  • Land Owner: GMC Properties
  • Developer: Gladstone Apartments Inc.
  • Amount of Units: 18
  • Project Details: N/A
  • Status: Pre-Construction

19. 421 Boivin Road, Elkford

  • Announced: September 25, 2024
  • Land Owner: District of Elkford
  • Developer: New Commons Development
  • Amount of Units: 65
  • Project Details: The Elk Valley Family Society will be the housing operator.
  • Status: Pre-Construction
  • Announced: April 4, 2025
  • Land Owner: Lake Babine Nation
  • Developer: Lake Babine Nation
  • Amount of Units: 20
  • Project Details: The project will be a mix of two-bedroom and four-bedroom units and BC Builds is also providing $36 million in financing.
  • BC Builds Grant: $1.8 million
  • Status: Under Construction (April 4, 2025)
  • Announced: April 4, 2025
  • Land Owner: Tsawout First Nation
  • Developer: Tsawout First Nation
  • Amount of Units: 16
  • Project Details: The project will have a mix of one-bedroom, two-bedroom, and three-bedroomm units and BC Builds is also providing $2.9 million in financing.
  • BC Builds Grant: $3.6 million
  • Status: Under Construction (April 4, 2025)
22. 2901 Glen Drive, Coquitlam
  • Announced: N/A
  • Land Owner: CLT Hoy Creek 2 Community Society (Community Land Trust)
  • Developer: TL Housing
  • Amount of Units: 146
  • Project Details: The project is being developed as part of a three-building project with a total of 396 affordable co-op housing units.
  • BC Builds Grant: $3,999,713
  • Status: Pre-Development

Total Amount of Units: 2,616

Total Funding Distributed (Grants Only): $77.1 million
